How HDPE Pipe Is Made: From Compound to Crate, Step by Step

Every HDPE pipe factory runs the same nine steps. What separates them is which of those steps they control and which they hope for. This is the line as it actually runs, with the point at each stage where a good pipe and a bad one part ways.

A PE100 extrusion line seen along its length, from the extruder through the cooling tanks to the haul-off
Written by Zhang Wei, Application Engineer, HDPE Factory11 min read

A pipe extrusion line is not complicated. Polyethylene granules go in one end, a continuous black tube comes out the other, and between them sit an extruder, a die, a calibration tank, a few cooling tanks, a haul-off and a saw. Any factory can buy that line. What a buyer is actually paying for is what happens at each station — the settings, the checks, and whether someone stops the line when a number drifts.

This article walks the line in order. At each step it says what the machine does, what can go wrong there, and what the result looks like when it reaches your site. The last section turns that into the four questions worth asking any supplier before a container is booked.

Nine stations of a PE pipe extrusion line in order: compound, extruder, die, vacuum calibration, haul-off, cooling, marking, saw or coiler, batch tests. The haul-off is highlighted because its speed against extruder output sets the wall thickness.Compound1Extruder2Die3Vacuumcalibration4Haul-off5Cooling6Marking7Saw / coiler8Batch tests9Wall thickness = extruder output ÷ haul-off speed. It is decided at station 5, not at the die.
The nine stations of a solid-wall PE pipe line. Wall thickness is set at station 5, not at the die — the haul-off speed against the extruder output is what fixes it.

1. Compound: the pipe is decided before extrusion starts

PE100 pipe is extruded from a pre-compounded resin: polyethylene with the carbon black, antioxidants and process stabilisers already blended in by the resin producer. The alternative — natural resin plus a black masterbatch dosed at the extruder — is cheaper and is where a great deal of substandard pipe begins. Masterbatch that is not fully dispersed leaves streaks of unprotected polymer that will chalk and crack in sunlight; a dosing unit that drifts leaves a batch with less than the 2 % carbon black that ISO 4427 requires.

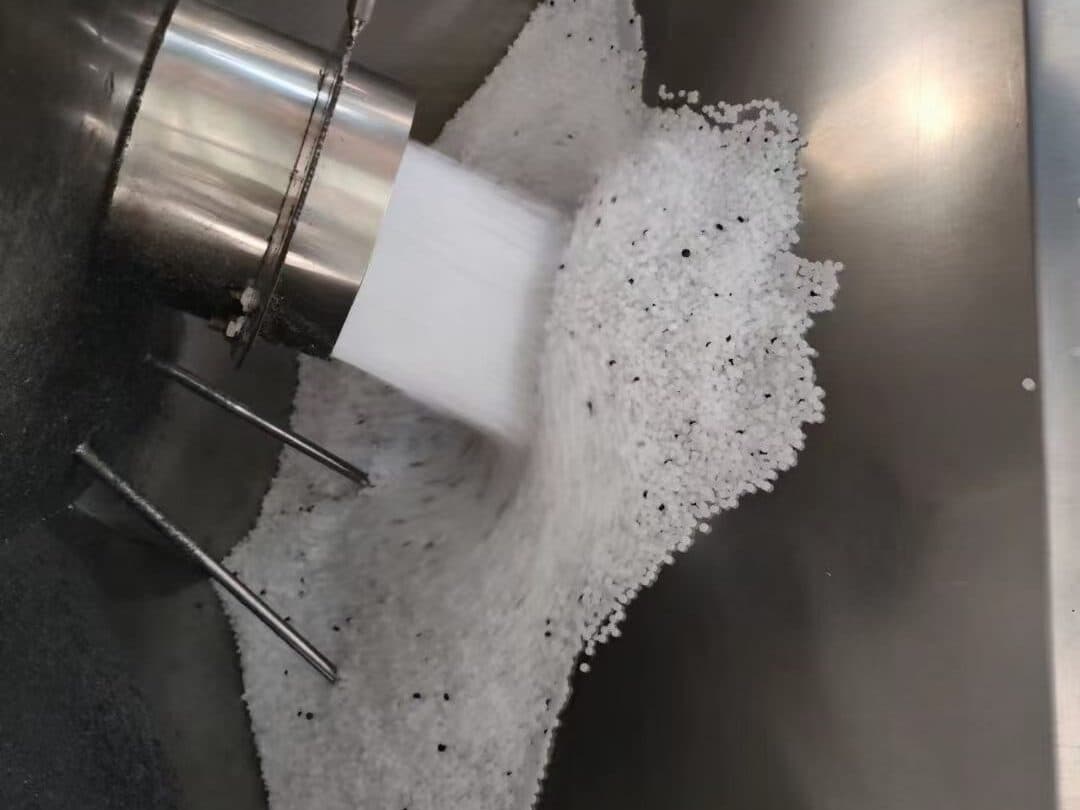

White PE100 compound granules with black masterbatch pellets pouring into a stainless-steel feed hopper
Compound entering the hopper. Every granule carries its own carbon black; nothing is being mixed here that could be mixed wrong.

2–3. Extruder and die: melting without degrading

A single-screw extruder melts the granules by a combination of barrel heat and the shear of the screw, then pushes the melt through a breaker plate into the die. Barrel zones run from about 180 °C at the feed to 210–230 °C at the head; the melt itself leaves the die at roughly 200–220 °C. Too cold and the melt is not homogeneous — you see it as unmelted specks or a matt, rough bore. Too hot, or too long in the barrel, and the antioxidant package is consumed before the pipe is even made, which shows up as a low OIT on the batch test and as brittle pipe years later.

The die forms the melt into a tube. Its spider legs — the struts that hold the mandrel — leave weld lines where the melt streams rejoin; a well-designed die and adequate melt pressure knit them so they are invisible and irrelevant. A worn or badly centred die produces wall that is thick on one side and thin on the other, which passes an average wall check and fails at the thin point under pressure.

The die head of a PE pipe extruder with the heater bands and the melt entering the calibration sleeve
Die head and the start of the calibration sleeve. Eccentricity is set here and corrected here — once the pipe is in the tank it is too late.

4–5. Vacuum calibration and cooling: where the dimensions are fixed

The hot tube leaves the die slightly larger than the finished size and is pulled through a water-cooled sleeve inside a vacuum tank. The vacuum draws the outer skin against the sleeve, fixing the outside diameter and freezing it in place; this is why a PE pipe's outside diameter is so consistent and why the standards specify OD rather than bore. The wall thickness, by contrast, is not set by any tool. It is the ratio of extruder output to haul-off speed: pull faster for the same output and the wall thins.

  1. 1

    Vacuum tank

    Sets the outside diameter and ovality. A tank at the wrong vacuum gives an out-of-round pipe; a sleeve that is scored leaves a longitudinal line on every metre.

  2. 2

    Spray cooling tanks

    Two to five tanks in series, depending on wall thickness, bring the pipe from a molten core to something a saw can cut. Thick-wall pipe cools from the outside in, so the bore is still soft long after the surface is hard.

  3. 3

    Cooling length as a limit

    The line speed for a given wall is limited by cooling, not by the extruder. A DN630 SDR 11 pipe with a 57 mm wall runs at a fraction of a metre per minute; a supplier quoting output rates that ignore this is quoting for thin wall.

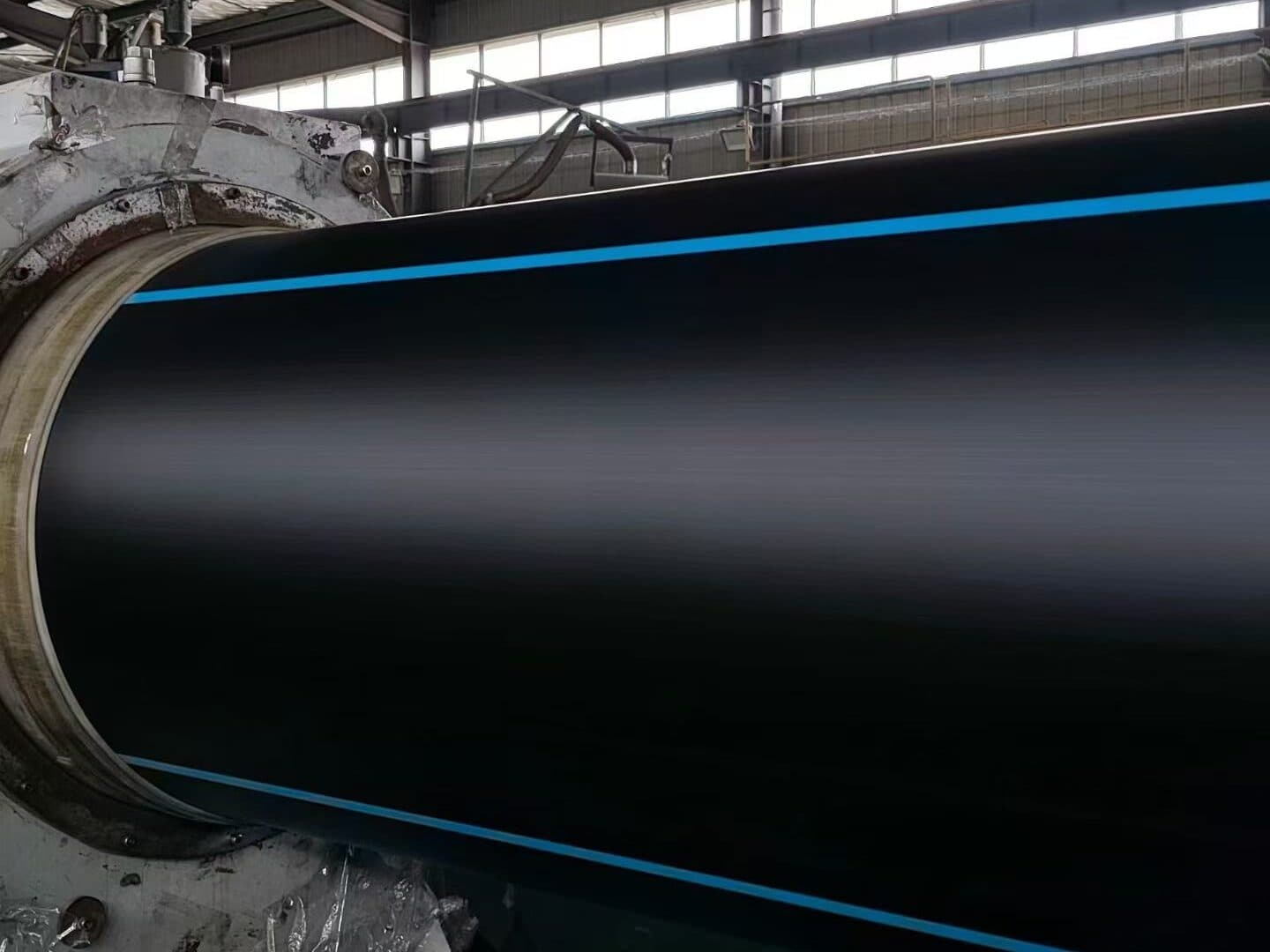

A large-diameter black PE100 pipe with blue stripes emerging from the vacuum calibration tank
Large-diameter pipe leaving calibration. The blue identification stripes are co-extruded at the die, not painted on, so they cannot wear off.

6–8. Haul-off, marking and cutting

The haul-off is a set of caterpillar tracks that grip the pipe and pull it through the line at a precisely controlled speed. Its speed against extruder output is the wall-thickness control loop; modern lines measure wall with ultrasonic gauges just after the calibrator and adjust the haul-off automatically. Ask whether the line has that gauge. A line without one relies on an operator with a caliper checking cut ends, which catches drift only after a length of pipe has been produced with the wrong wall.

Marking comes next. ISO 4427-2 requires, at intervals of no more than one metre, the standard number, nominal size and SDR, material grade, pressure class, manufacturer and a production code that traces to the batch. The marking is the pipe's identity — a pipe that reaches site without it cannot be tied to a test certificate, and an inspector is right to reject it.

The inkjet marking line on a PE100 pipe showing the standard, DN, SDR, PN and material grade
Every metre carries the same line. If the marking on the pipe in your yard does not match the certificate in your file, one of them is wrong.

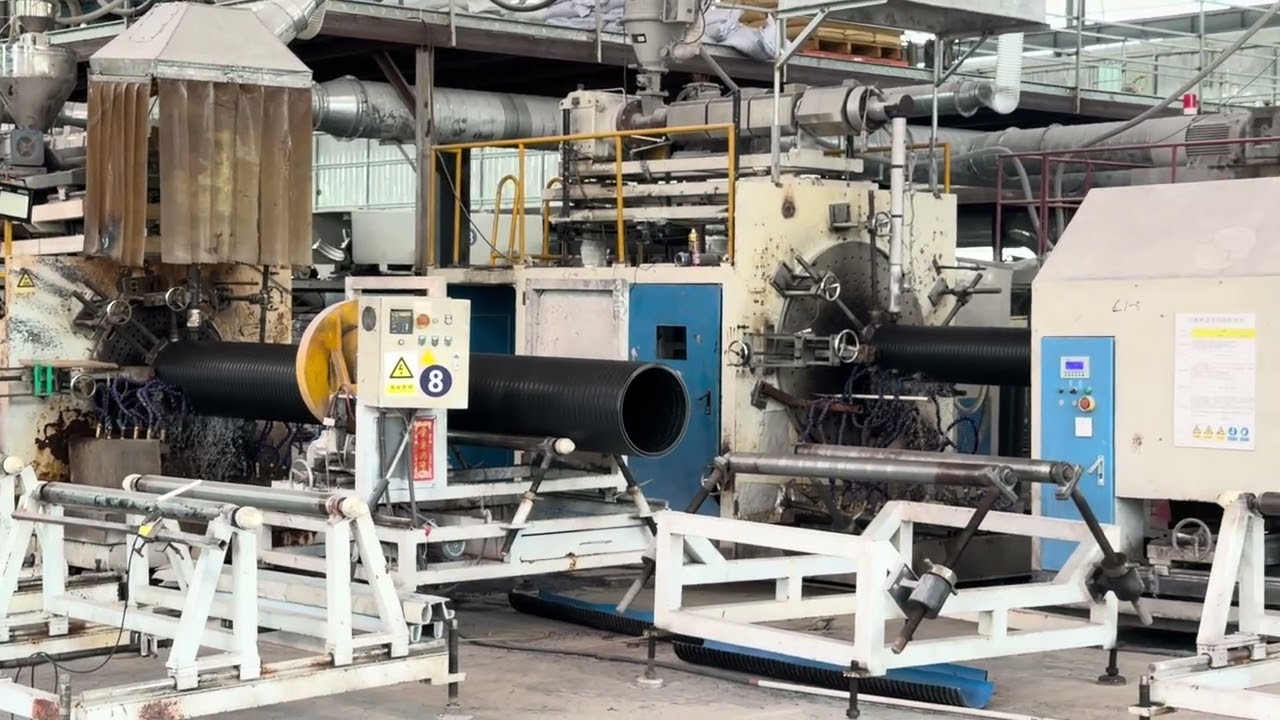

The line at running speed. The haul-off tracks at the far end are what set the wall; the extruder sets only how much material arrives per second.

The saw cuts straight lengths — 6 m, 11.8 m or 12 m to suit the container — square to the axis, which matters because a butt-fusion machine faces the ends but a badly cut end wastes pipe. Small sizes bypass the saw and go to a coiler, where the pipe is wound while still slightly warm so it takes the coil without kinking.

9. Batch tests: the part that separates factories

Everything up to this point produces a pipe that looks right. The batch tests are what prove it is right, and they are where a low-cost factory saves its money: the tests take hours to days, tie up a laboratory and occasionally fail a batch that has already been made. A factory that does them holds the batch until results clear. One that does not ships on appearance.

Routine tests on a PE100 pipe batch to ISO 4427-2
TestMethodRequirementWhat a failure means
Dimensions and ovalityISO 3126OD and wall within ISO 4427-2 Table 2 tolerancesHaul-off drift or a worn calibrator
Melt mass-flow rateISO 1133, 190 °C / 5 kgWithin ±20 % of the compound's MFRPolymer degraded in the barrel
Oxidation induction timeISO 11357-6, 200 °C≥ 20 minStabilisers consumed by over-heating or poor compound
Carbon black contentISO 69642.0–2.5 % by massUnder-dosed masterbatch; no UV protection
Longitudinal reversionISO 2505, 110 °C≤ 3 %Cooled too fast; locked-in stress
Hydrostatic strength, 20 °CISO 1167, 12.0 MPa hoopNo failure in 100 hWrong material grade or a wall defect
Hydrostatic strength, 80 °CISO 1167, 5.4 MPa / 5.0 MPaNo failure in 165 h / 1 000 hSlow crack growth resistance below PE100
Requirements are those of ISO 4427-2 for PE100 pipe. EN 12201-2 and GB/T 13663.2 apply the same tests with the same limits. The 1 000-hour test is the one most often skipped: ask to see it on a certificate dated within the last month.
A digital caliper measuring the wall of a freshly cut PE100 pipe end beside the printed marking
The first check on every cut end, and the last check before a batch is released. It takes ten seconds and it catches the most common defect.

What to ask before you order

  • Is the pipe extruded from pre-compounded PE100, or from natural resin plus masterbatch? Ask for the compound producer and grade name.
  • Does the line have an inline ultrasonic wall gauge, or is wall checked by hand at the saw?
  • Which of the batch tests in the table above are run on every batch, and which only on request? Ask for a recent certificate with batch numbers.
  • Is the batch held until the 165-hour test clears, or shipped on dimensions and appearance?

None of those questions is unusual and a serious factory will answer all four in an afternoon. The answers say more about what will arrive in the container than any brochure does.

Sources and standards

Frequently asked questions

Why is HDPE pipe specified by outside diameter rather than bore?
Because the outside diameter is what the process controls. The vacuum calibration sleeve fixes the OD to within a fraction of a millimetre, while the bore follows from OD minus twice the wall and varies with SDR. Fittings are therefore made to the OD, and the same DN110 fitting fits SDR 11 and SDR 17 pipe alike.
Can the blue stripes on water pipe wear off?
No. They are co-extruded — a second small extruder feeds blue compound into the die so the stripe is part of the wall, typically 0.5–1 mm deep. Paint would wear off in handling; a co-extruded stripe survives until the pipe does.
How is wall thickness controlled if no tool sets it?
By the ratio of extruder output to haul-off speed. The extruder delivers a fixed mass per second; the haul-off decides how much length that mass is stretched over. An ultrasonic gauge after the calibrator measures the wall continuously and trims the haul-off speed to hold it.
What is the difference between pipe made from compound and pipe made with masterbatch?
Pre-compounded PE100 has carbon black and stabilisers dispersed by the resin producer under controlled conditions and certified as a compound. Masterbatch is added at the extruder and depends on the extruder's mixing and the dosing unit's accuracy. ISO 4427 permits both, but every failure we have seen for UV chalking or low carbon black was masterbatch pipe.
How long does a batch test take?
Dimensions, MFR, OIT and carbon black are same-day. The 20 °C hydrostatic test runs 100 hours and the 80 °C tests 165 and 1 000 hours. A factory that ships within days of extrusion cannot have completed the long tests on that batch; ask whether the long tests are run on a rolling basis with results from recent batches of the same compound.
